Simplified intelligent completion architectures improve zonal control economics
ALAN MCLAUCHLAN and WILLIAM ALVES, Halliburton
Operators face sustained pressure to reduce well-delivery costs while managing rising architectural complexity and execution risk. Intelligent completions—once limited by slow hydraulic actuation cycles, bulky infrastructure and perceived operating friction—now operate within a pragmatic, economics-first phase.
In deepwater and complex reservoir developments, cost pressure remains intense. Representative deepwater rig rates often exceed $750,000 per day, and completion operations can account for as much as 40% of total well expenditure. Operators must, therefore, extract maximum value from every dollar invested in hardware, installation time and long-term intervention.
In practice, three primary factors drive intelligent completion cost and risk: the complexity of umbilicals and control lines; the rig time required for installation and testing; and the potential for deferred or lost production, caused by physical interval control valve (ICV) operation. These issues intensify in multizone deepwater wells, where traditional hydraulic systems may require six to eight lines—such as subsurface safety valves (SSSV), ICVs, permanent downhole gauges and chemical injection—for just three to four zones. This increases subsea infrastructure costs, raises installation risks and reduces scalability, if more zones are added, thereby further boosting inventory and CAPEX expenses, Fig. 1.
A second, less visible cost driver relates to ICV functionality. Incremental hydraulic ICVs require sequential pressurization and vent cycles to reach a new choke setting. In subsea environments, even a single adjustment can take hours. When multiple zones require adjustment, teams often avoid optimization. This avoidance leads to missed recovery and conformance benefits because of slow response times, competition with production and potential execution risk—not because the reservoir lacks value. In some cases, operators may only seek verification of ICV functionality or make minor adjustments to the choke position; however, these actions can still cause valve closure and lead to production shut-in.
Two advanced architectures now provide practical, scalable standardized configurations suitable for any zone density, including bidirectional capability. These architectures pair with proven ICVs that address previous limitations and strengthen the link between reservoir objectives and surface operations. These capabilities are delivered through established all-electric and electro-hydraulic intelligent completion systems.

ALL ELECTRIC SYSTEMS: MAXIMUM SIMPLIFICATION AND FASTEST RESPONSE
All-electric architecture removes hydraulic fluid from the ICV to the surface. Power and control are transmitted through a single electrical line, which reduces the complexity of the umbilical bundle and associated infrastructure. This advantage proves especially important in ultra-deepwater and long-offset tiebacks, where hydraulic time constants and infrastructure scaling limit traditional design viability, Fig. 2.
Functional benefits include real-time, bidirectional positioning with response times that range from seconds to minutes, compared with traditional response times of hours or days for conventional systems. The architecture also offers seamless integration with existing subsea hardware and electrical feedthrough connectors. Reliability improves through advanced condition monitoring, rigorous qualification programs that incorporate fewer, more precise splices in the well, and two-way choke adjustments as a standard practice. This approach shifts effort from deferred maintenance to routine operations.
From a development planning perspective, greenfield projects with step-outs of about 15 to 20 km or water depths greater than about 2,000 m increasingly identify all-electric systems as the lowest-risk, most cost-effective option when operators account for rig hours, umbilical size and future optimization.
The all-electric system architecture also provides greater flexibility for instrument integration into its configuration, which allows operators to supplement the well solution with expanded insights into downhole conditions.

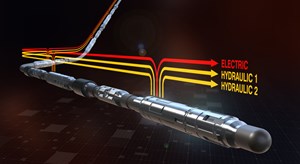

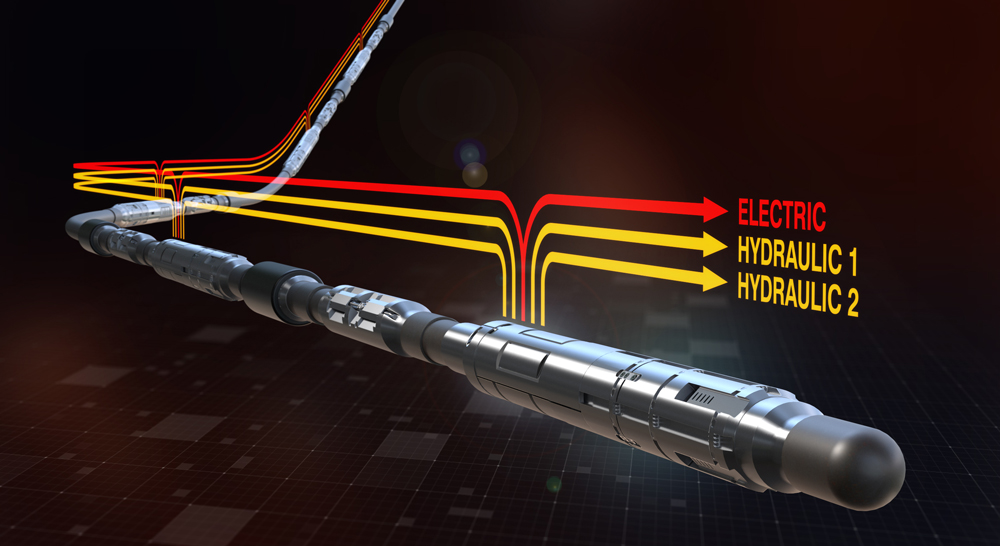

ELECTRO-HYDRAULIC SYSTEMS: HIGH FORCE WITH DIGITAL PRECISION
Electro-hydraulic architecture combines familiar hydraulic force and fail-as-is behavior, in which the ICV remains in its last set position during a loss of power or control, with electrically supported control. Halliburton deployed these ICVs for nearly three decades, which provides a lower-friction adoption path for applications that rely on legacy infrastructure or established hydraulic operating philosophies, Fig. 3.
Electro-hydraulic ICVs remain compatible with standard subsea equipment (feedthroughs, trees) and require only one electrical line and two hydraulic lines—regardless of the number of zones deployed. Operators widely deploy these systems in wells with high zone counts, including installations with up to 12 zones with gauge integration. These systems serve as a practical bridge for teams that scale beyond conventional designs.
Electro-hydraulic designs combine actuation force and familiar hydraulic behaviors with the precision and data bandwidth of electrical control. This capability allows last-minute zonal adjustments at the rig, without disruption to hydraulic and electrical support systems. When paired with the proven ICV system, the electro‑hydraulic architecture delivers high mechanical force for large-bore or high-differential-pressure valves.
This system also provides integrated position feedback, bidirectional communication, real-time downhole data and rapid zonal control within seconds. These capabilities support advanced reservoir management and control that conventional hydraulic ICVs cannot deliver.
Integration with existing interface hardware remains especially attractive when hydraulic infrastructure already exists or when operators prefer continuity with established procedures to manage adoption risk.
WHERE THE SAVINGS ORIGINATE: CAPEX, OPEX AND PRODUCTION
Both all-electric and electro-hydraulic architectures deliver a common benefit: scalable, intervention-free and advanced remote bidirectional zonal control that converts reservoir data into immediate production decisions. Cost savings occur throughout different project phases.
CAPEX savings. These result from fewer control lines, which reduce umbilical size, complexity and cost—often by hundreds of thousands to millions of dollars per well. Simplified architecture shortens make-up, testing and valve operations, which reduces rig time on the critical path.
OPEX savings. These result from low-maintenance requirements and real-time position feedback. Operations achieve faster, direct positioning within minutes, rather than hours, which supports more responsive reservoir control and limits deferment without production shut‑ins. Fewer splices and faster valve actuation also support simpler deployment.
Reservoir performance improves through permanent downhole sensing and minute-level actuation. Teams can choke back high-water-cut or gas-breakthrough intervals, address conformance issues more directly and sustain drawdown targets in multizone horizontal wells with selective control.
EXECUTION SIMPLIFICATION: FROM YARD TO FIRST OIL
In the workshop, electric-hydraulic and all-electric architectures reduce or eliminate hydraulic power units and hydraulic line flushing. Shorter assembly make-up time supports optimized field deployments within different zone configurations.
On deck, smaller footprints and simplified line management reduce manual handling, ease last-minute zone changes and expand opportunities for task parallelization and crew efficiency. These changes can reduce total hours and limit health, safety and environmental exposure in the red zone, factors that often dominate schedule variance despite limited visibility in component pricing.
Actuation time on the critical path decreases from hours to minutes. The SmartWell® Turing® electric-hydraulic control system and the SmartWell® Volta™ all-electric control system ICVs move directly to target choke positions without intermediate steps, which allows for onstream adjustment, rather than production deferral. Improved response time and position accuracy also support automated workflows, including threshold detection, analytics validation and coordinated movement throughout multiple zones and wells. Because both systems use electrical technology, more downhole equipment information can be accessed to support health monitoring and facilitate diagnostics and prognostics of the equipment.
FIELD-GROUNDED EVIDENCE AND DIRECTIONAL SCENARIOS
In the Middle East, a high-zone intelligent completion with an electro-hydraulic installation that had approximately 12 zones in an extended-reach lateral demonstrated a targeted response to early water ingress in specific intervals, while sustained production persisted elsewhere. This case confirmed practical, rapid bidirectional control, rather than just more zones on paper.
In typical multi-zone scenarios, electric ICV systems can cut critical-path rig time by about 50%, compared to similar hydraulic systems. Because rig hours strongly influence installation emissions, shorter duration can prevent tens to hundreds of tons of CO₂ per well, depending on the number of zones and completion depth.
A PRACTICAL DECISION FRAMEWORK FOR OPERATORS
When operators select an intelligent completion architecture, a structured approach that links reservoir objectives to lifecycle economics supports better outcomes:
Assess reservoir uncertainty and optimization frequency. Highly heterogeneous reservoirs with frequent adjustment requirements favor electro‑hydraulic or all‑electric systems that simplify optimization and support routine adjustments. These systems also support automated workflows that incorporate advanced data insights into digital advisor platforms, such as the Clariti™ digital reservoir management suite or Visum® wellbore insight platform. These platforms recommend optimal valve positions or operations within defined parameters, which lead to subtle yet significant improvements in reservoir management.
Evaluate infrastructure limitations. Both architectures use the unified controller card (UCC), which supports installation in existing subsea and dry-tree setups and provides operators the flexibility to delay final completion design configurations or control methods until later in the project. It facilitates a smooth transition to either technology, using the same interface. During workover operations, this feature allows operators to replace older-generation systems with newer electro-hydraulic or all-electric systems without affecting the existing hardware integration.
Consider subsea tie-back length and dynamics. Hydraulic actuation time increases with distance. Electro-hydraulic systems reduce this delay by eliminating pulsed pressure and vent cycles for each position. Electric actuation remains consistent for a specific topology, regardless of tie-back length.
Review infrastructure constraints. In brownfield developments, space constraints often limit intelligent completion deployment. Electro‑hydraulic systems reduce footprint, while all‑electric architectures eliminate hydraulic power units and rely on existing control‑room space.
Model full lifecycle economics. Operators can, and should, combine capital savings from reduced lines, umbilicals and rig time, along with operating savings from intervention avoidance and production optimization. Umbilical and control-line counts should serve as primary cost and risk factors, not as afterthoughts.
TWO ARCHITECTURES, ONE OBJECTIVE: MAXIMIZE ASSET VALUE
Intelligent completions are now accessible beyond high-end projects. All-electric and electro-hydraulic systems deliver proven, scalable solutions that reduce costs, limit risks and increase reservoir value. Streamlined architecture, real-time data, and rapid, selective bidirectional control convert completions from a static setup into dynamic reservoir management tools that support more responsive reservoir management throughout the life of the well.
All-electric and electro-hydraulic intelligent completions are not competing methods. Rather, each represents an established, practical solution that can help streamline operations, facilitate real-time data and control and connect reservoir management directly to economic results. In multi-zone and long tie-back projects, where every minute matters, both systems deliver substantial gains in usability and speed—especially when integration with existing infrastructure is required.
Through simplified architecture, reduced actuation time and routine selective zonal control, intelligent completions increasingly support practical, life‑of‑well reservoir management by combining reservoir control with fewer hours, fewer components, fewer interventions, lower CO₂ emissions and more barrels onstream, throughout the life of the well.
ALAN MCLAUCHLAN began his career with Halliburton in 1997 and was part of the team that installed Norway’s first intelligent well. Mr. McLauchlan has held roles in operations, engineering, business development and regional leadership, with global experience in Europe, Africa, the Gulf of America, Brazil and Asia. He currently supports the development and commercialization of the next generation of all-electric completions technology.
WILLIAM ALVES brings experience in intelligent completions and broader oil and gas operations. He began his career as a field engineer, where he supported the installation, commissioning and troubleshooting of advanced downhole systems. Mr. Alves later moved into engineering and business development roles. Based in Rio de Janeiro, Brazil, he supports global completion tool portfolios and leads product strategy, system integration and cross-functional collaboration for intelligent, digital and all-electric completion solutions.
